West Side Drainage Improvement Project
Overview
The City has conducted multiple studies to evaluate drainage improvements that would provide flood relief to the west side of the city. The recommended solution was presented to the City Council by Halff Associates in November 2023 and includes:
- adding a new storm sewer trunk line within the ELPH corridor (Bissonnet Street south to Brays Bayou),
- rerouting existing storm sewer network on the west side of the city for efficiency and directing the storm sewer to the new trunk line, and
- upsizing storm sewers throughout the west side of the City.

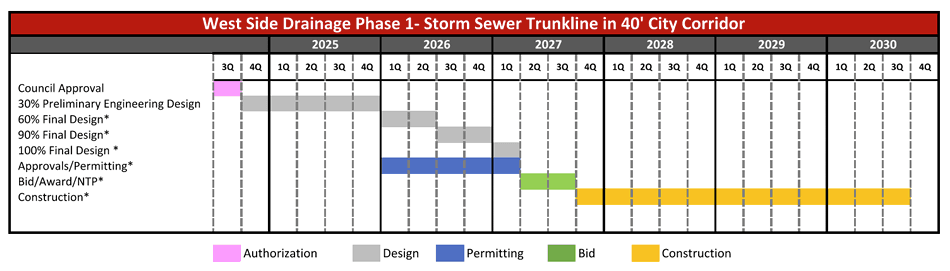

The recommended solution is a multi-phase project that will occur over several years. The first phase of the project is to construct the new storm sewer trunk line within the 40-foot-wide ELPH property.
On September 9, 2024, the City Council approved the Design Contract with HDR Engineering. The preliminary design is expected to last 15 months, and the final design and approvals will take approximately 13 months to complete.
To sign up to receive notifications about the West Side Drainage Improvement Project, visit the NotifyMe.
Project History
2025
- April 28 - Phase 1 Trunkline: Drainage Alternative Analysis Presentation to the City Council
2024
- September 9 - The City Council approved a Professional Services Agreement with HDR Engineering, Inc. to complete preliminary and final design plans for the new storm sewer trunkline (Phase 1).
2023
- November 13 - Additional Drainage Modeling presentation final update
- August 14 - Additional Drainage Modeling update
- May - Preliminary Engineering Report Approved
- February 13 - Westside Drainage Improvements Preliminary Engineering Report Update #4
2022
- December 12 - Westside Drainage Improvements Preliminary Engineering Report Update #3
- April 11 - Westside Drainage Improvements Preliminary Engineering Report Update presentation to the City Council #2
2021
- July 26 - Westside Drainage Improvements Preliminary Engineering Report Update #1
2020
- December 14 - PER Contract Awarded to Cobb-Fendley
- July 27 - City Council Workshop on Drainage/Modeling Study
- July 20 - City Council Workshop on Storm Water Drainage System Modeling Study
- July 13 - City Council Workshop on Storm Water Drainage System Modeling Study
- June 22 - City Council Workshop on Modeling Study of the City’s Storm Water Drainage System
2019
- April 22 - Citywide Drainage Study – Final Report
2018
- July 8 - Citywide Drainage Study – City Council presentation
- June 25 - Citywide Drainage Study – City Council presentation
- April 23 - Citywide Drainage Study - City Council presentation
Contact Us
-
Eduardo Barreto
Capital Projects Manager
713-662-5848
Contact Eduardo BarretoPublic Works Administration
3826 Amherst
West University Place, TX 77005Public Works Customer Service
Phone: 713-662-5839
After-Hours Emergency
Phone: 713-668-0330
