2025 Certificates of Obligation
At its regular meeting on September 8, the City Council unanimously authorized a Notice of Intent to issue Certificates of Obligation (COs) for various water system infrastructure projects and the West Side Drainage Improvement Project, as identified in the City’s 2025 – 2034 Capital Improvement Plan (CIP).
The total bond proceeds will be approximately $10.76 million.
On November 10, the City Council authorized the sale of COs, not to exceed $10.76 million. The City's 'AAA' rating was affirmed by S&P Global Ratings, guaranteeing that the city received the best interest rates for this issuance.
2025 Notice of Intent to Issue COs
- West Side Drainage Improvement Project – Design ($342,000)
- Between 2021 and 2023, the City completed the Preliminary Engineering Study for the West Side Drainage Improvements, which helped identify feasible alternatives for moving storm water out of West U to Brays Bayou.
- Due to the complexity of the project, further modeling analysis was completed between 2023 and 2024.
- In 2024, the City acquired property that provides the ability to construct a new storm sewer trunk line along the west side of the City from Bissonnet St. all the way to Brays Bayou. This new trunk line lessens the burden on the existing storm sewer system and Kilmarnock Ditch.
- This issuance will provide funding for the City to explore future internal storm sewer improvements for the west side that were not previously possible.
- Cast Iron Water Line Replacement – Construction ($2,941,000)
- This project will replace pre-1939 cast iron water lines throughout the city. Replacing these water lines prior to failure will prevent more costly repairs and unplanned service disruptions.
- Wakeforest Water Plant Distribution Line Replacement – Construction ($5,480,000)
- This project will construct improvements to the water distribution system in the northeast corner of West U, which will have the benefits of improving water pressure to the immediate area and throughout the rest of the city.
- Milton Water Plant Improvements – Design ($818,000)
- The Milton Street Water Pump Station was constructed in 1957. This project will design improvements to upgrade the pump stations at this facility with additional pumping capacity to meet current and future needs, as well as replace two ground storage tanks (400K and 1.5 Million Gallon (MG)) with a dual 2.0 MG ground storage tank at the site. The dual tank (a tank within a tank) will replace the two single tanks.
- Wakeforest Elevated and Ground Storage Tanks Interior Rehabilitation – Design and Construction ($1,175,000)
- The City has substantially completed exterior maintenance on the Wakeforest Elevated Storage Tank (EST) and Ground Storage Tanks (GSTs), which is completed every 15 years and helps extend the useful life of the tanks.
- This work will complete the maintenance work on the interior of the EST and GSTs. This project will include new interior coatings, cathodic protection systems, and other work necessary to maintain the tanks’ compliance with various regulatory agencies and extend their anticipated service life.
- As a majority of the projects associated with this bond issuance are related to West U’s water system, the debt issued for these projects will be paid for by water/sewer fees, not property taxes.
- The city is anticipated to increase water and sewer rates in 2026, and a portion of the recommended increase is to support the issuance of these COs.
- The estimated impact is an additional $2.36 per month for the average household, which typically uses 9,000 gallons and does not receive a senior or disability exemption on its West U utility statements.
- The total anticipated issuance to be funded by ad valorem taxes is $342,000.

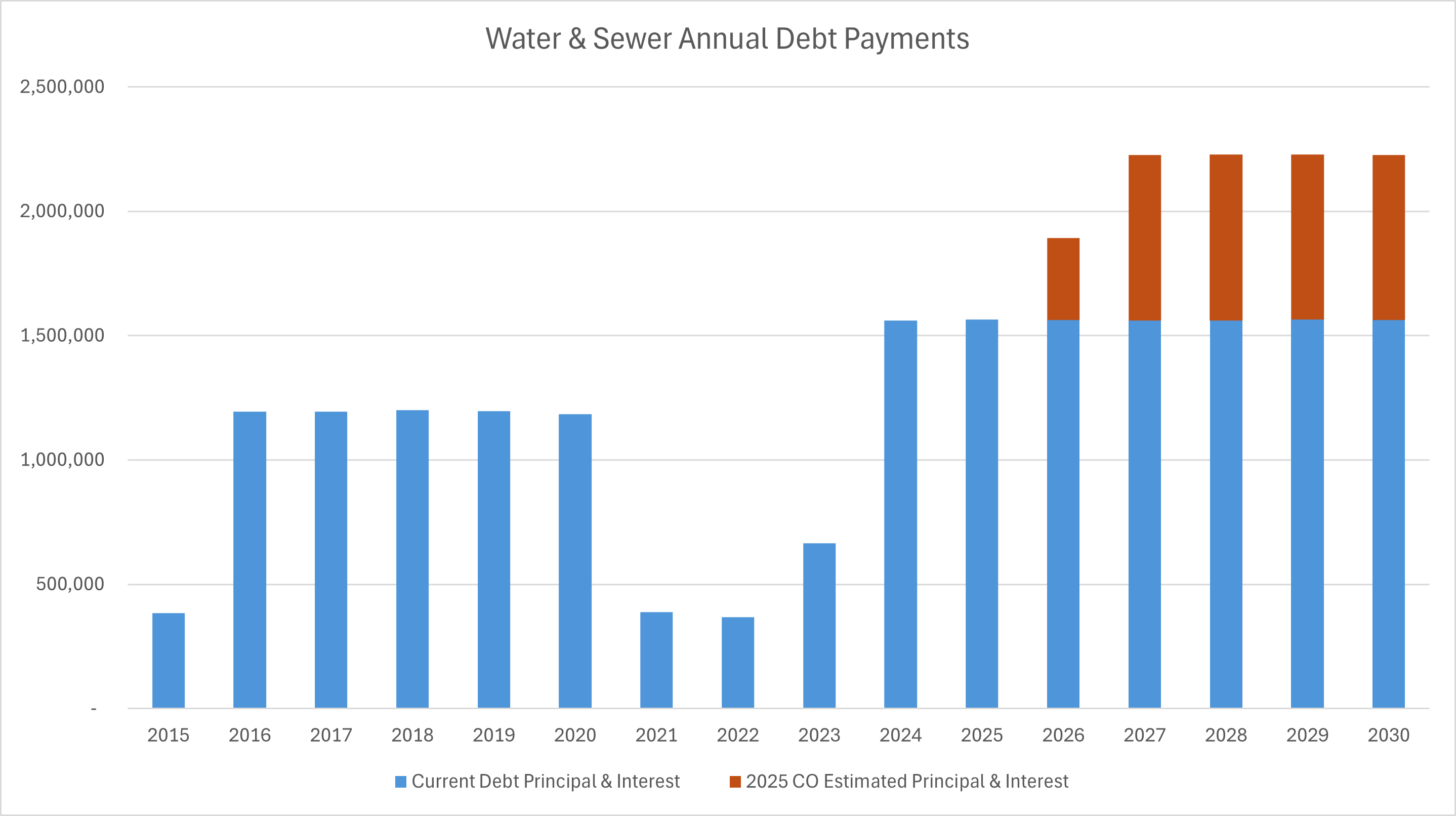

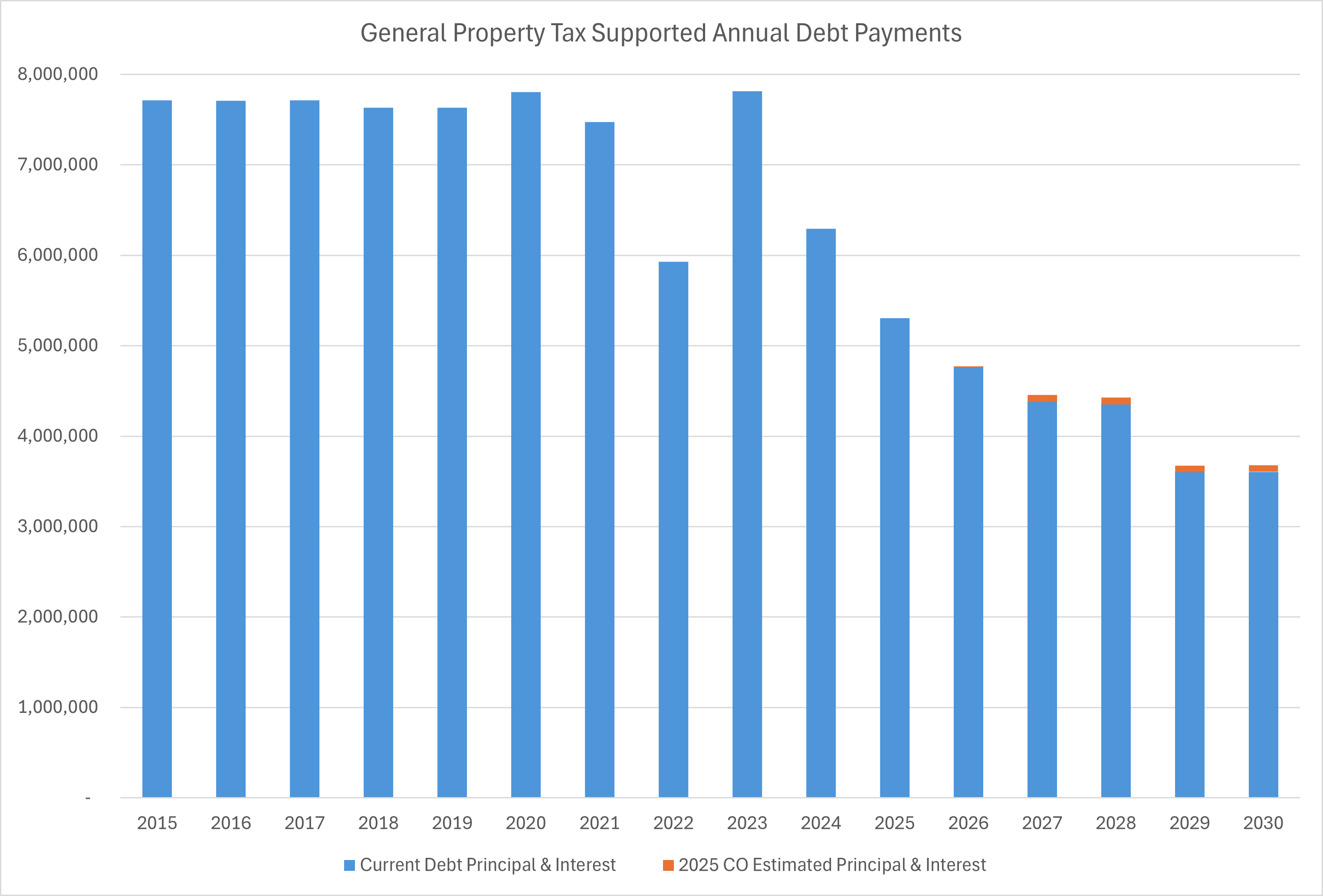

The graphs below illustrate the city's historical and current annual debt payments, and the projected effects of the 2025 issuance over the next five years. These projections do not account for future debt issuances.
- January 27, 2025 – City Council held a discussion at its regular meeting regarding funding opportunities for various capital projects
- February 10, 2025 – City Council discussed and accepted the FY 2025 – 2034 CIP
- July 14, 2025 – City Council held a discussion regarding the FY 2026 – 2035 CIP which included an update on current projects and those identified for potential debt issuance in 2025.
- August 11, 2025 – City Council held a discussion at its regular meeting regarding updates to the FY 2026 – 2035 CIP, funding options, and issuing debt
- September 8, 2025 – City Council authorized a Notice of Intent to issue COs
- November 10, 2025 - City Council authorized the sale of COs, not to exceed $10.76 million.
Please note: This is a comprehensive list of City Council meetings in 2025 that discussed capital project funding. This list does not include instances where the design or construction of specific projects were discussed during City Council meetings, other public forums, or general communication from the city.
